U.S. Flag An official website of the United States government

Integrated Delivery Schedule (IDS)

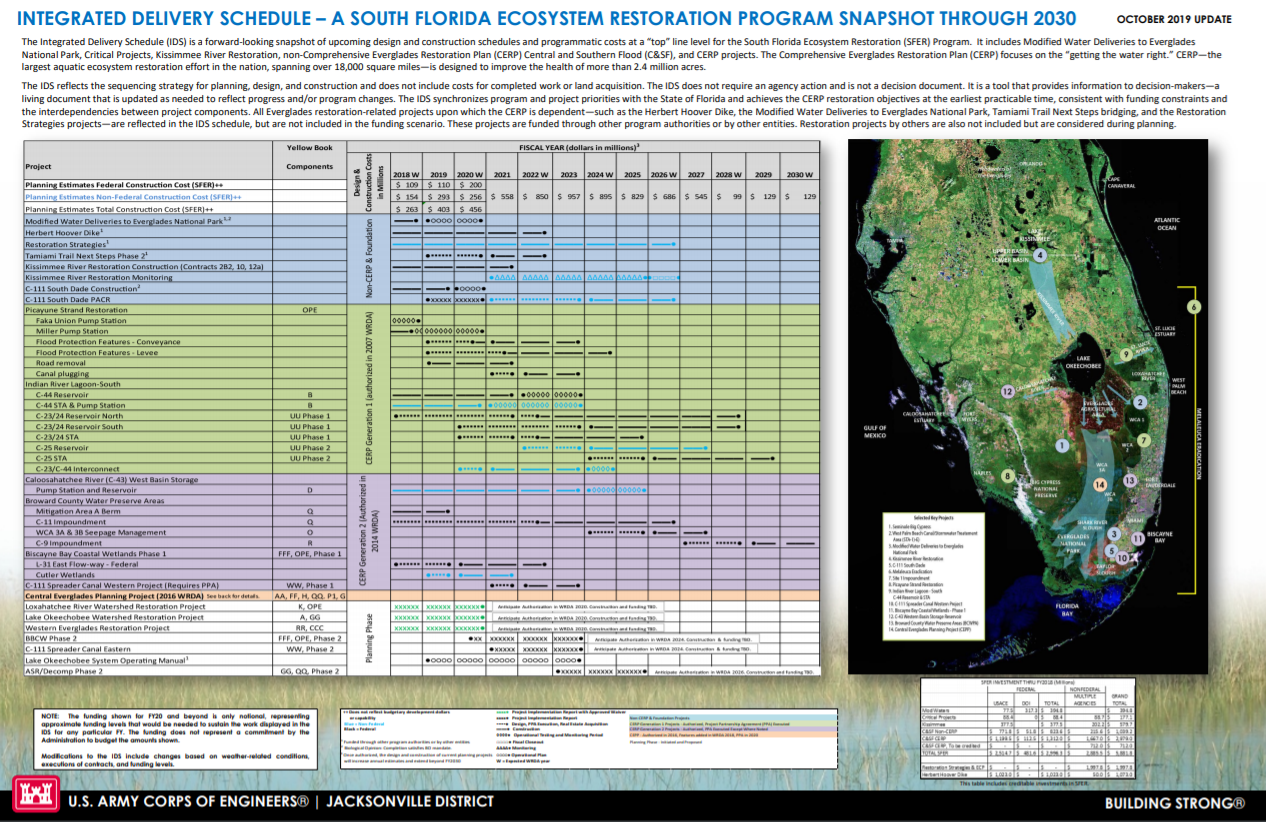

Integrated Delivery Schedule. The Integrated Delivery Schedule (IDS) is a forward-looking snapshot of upcoming design and construction schedules and programmatic costs at a “top” line level for the South Florida Ecosystem Restoration (SFER) Program.
